[  Why It Matters  ]

Most patio failures look bad three or four winters in: flaky surface, hairline cracks branching across the slab, the corner that's settled an inch and shed water back toward the house. Almost all of it goes back to what's underneath — not enough stone base, the wrong concrete mix for our winters, or no planned crack-control lines. Get those right and a patio quietly does its job for thirty years.

[  Recent work / Two from the file  ]

A different home. The same approach.

Stamped concrete patio in an ashlar-slate pattern behind a 1990s King of Prussia colonial home with cream siding and burgundy shutters, with Adirondack chairs around a built-in stone fire pit at late-summer afternoon golden hour

P.01 · Recent project

Concrete

A wood broom leaning against a freshly broom-finished concrete patio slab with wood forms still in place, with a brick Conshohocken twin home in soft focus background, late afternoon side-light raking across the wet surface

P.02 · Craft detail

Concrete

[  Mid-pour · Layered Build-up  ]

Build-up · Concrete Patios.

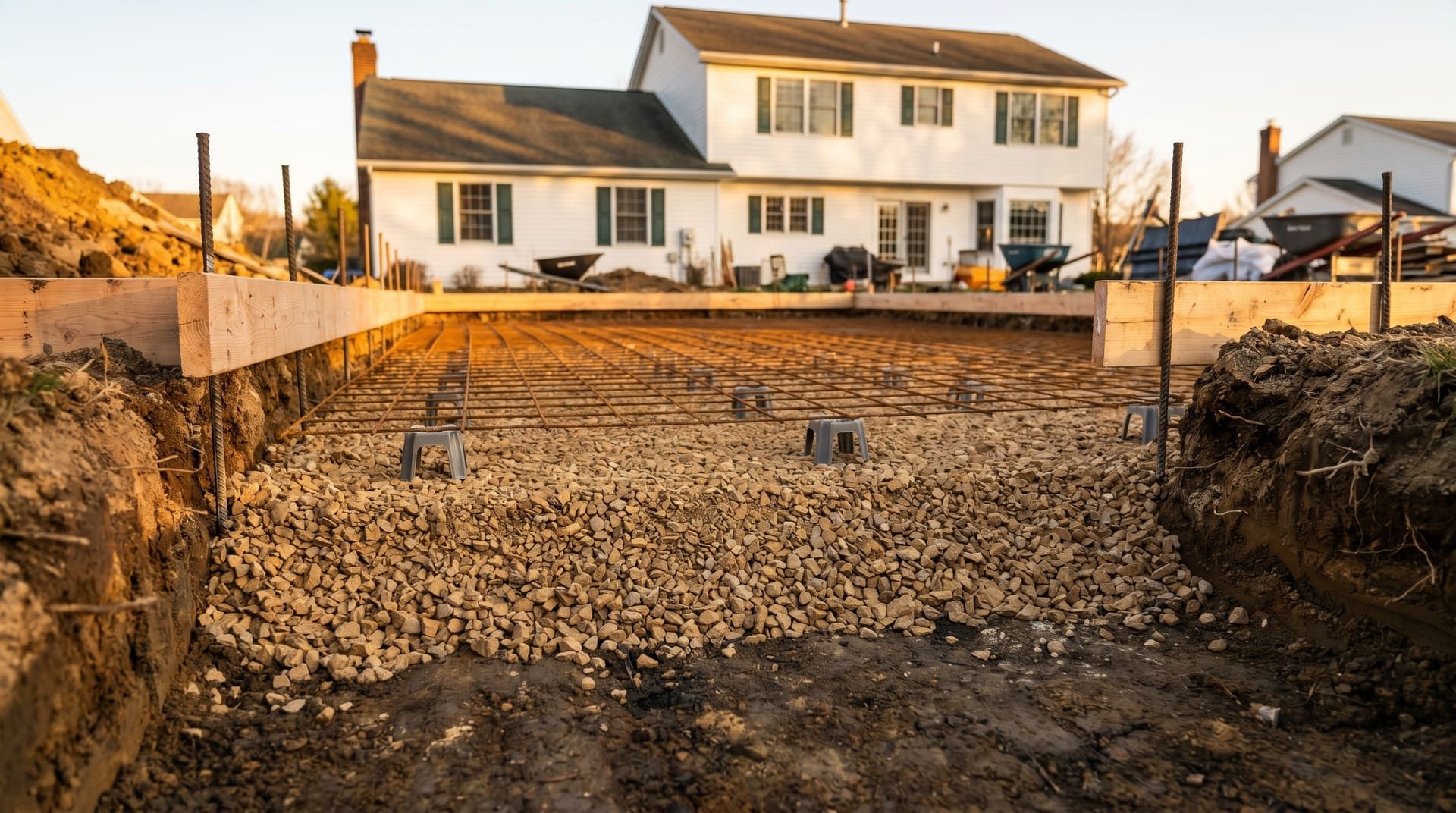

Mid-construction backyard patio in suburban Pennsylvania before the concrete pour, showing the excavated rectangular pit with packed crushed stone base, wire mesh reinforcement on chairs, and wood forms staked around the perimeter at finish grade 1 2 3 4 5 6
  1. 1

    Compacted soil base

    Excavated 10–12 in. — stable foundation for everything above

  2. 2

    Compacted stone base

    6–8 in.

    Drains water, gives the slab a level bed

  3. 3

    Vapor barrier

    Blocks ground moisture from wicking into the slab

  4. 4

    Reinforcement

    Wire grid or fibers — keeps cracks tight

  5. 5

    Concrete slab

    4 in.

    Freeze-resistant mix that won't flake

  6. 6

    Crack-control cuts

    Every 8–10 ft — controls where the slab cracks

"Most failed patios aren't a concrete problem. They're a what's-underneath-the-concrete problem."

[  Field Note / Patios  ]

[  Finish Library / 4 Options  ]

Pick the surface. Spec carries through to all of them.

  • Close-up detail of a freshly broom-finished concrete surface with parallel brush striations on medium-gray concrete
    F.01

    Finish

    Broom

    Most durable / lowest maintenance

    Standard for working patios

  • Close-up detail of an exposed-aggregate concrete surface with smooth river pebbles in tan, gray, brown, and white tones embedded in cement paste
    F.02

    Finish

    Exposed Aggregate

    Slip-resistant / hides wear

    Pebble seed embedded then washed

  • Close-up detail of stamped concrete patterned to look like irregular ashlar slate with crisp recessed grout joints between blue-gray and tan stone faces
    F.03

    Finish

    Stamped

    Durable when substrate is spec-correct

    Patterned to mimic stone or brick

  • Close-up detail of concrete pavers laid in a tight herringbone pattern in muted natural-stone tones with tight polymeric joint sand in the seams
    F.04

    Finish

    Paver

    Replaceable units / no slab cracking

    Polymeric sand and plate compaction

[  Pricing / Per Square Foot  ]

Investment range for concrete patios.

Broom-finish flatwork

$18 $28 / sq ft

Stamped concrete

$22 $35 / sq ft

Paver patio

$25 $42 / sq ft

Every quote is line-itemed — base, concrete, forms, finish, and removal listed separately.

[  Specification Sheet  ]

Build spec.

  • S.01

    Stone base depth

    6–8 in. of compacted stone — drains water, stable bed

  • S.02

    Concrete thickness

    4 in. — for foot traffic and patio furniture

  • S.03

    Concrete mix

    4,000 psi freeze-resistant mix — won't flake in winter

  • S.04

    Crack-control lines

    Every 8–10 ft — controls where it cracks

  • S.05

    Steel reinforcement

    Wire grid or fibers — keeps cracks tight

  • S.06

    Forms (the wood frame)

    2× lumber, staked and leveled — sets slab edges

  • S.07

    Drainage slope

    1/8 in. per ft, sloped away from the house

  • S.08

    Curing time

    Walk on it in 24–48 hrs; full strength at 28 days

[  Frequently Asked  ]

Common questions about concrete patios.

  1. Q.01

    How long does a concrete patio last in Pennsylvania winters?

    A patio built right — winter-rated concrete on a deep packed-stone base, with planned crack-control lines cut on time — should last 30 to 40 years in Pennsylvania with very little maintenance. The mix matters: winter-rated concrete is made with tiny air pockets inside the paste that give water somewhere to go when it freezes, so the surface doesn't flake or crack from inside. Patios that fail in five to ten years were almost always poured in plain (non-winter-rated) concrete, or on too thin a base.

  2. Q.02

    Do I need a permit for a concrete patio in Montgomery County?

    It depends on the township. In Upper Merion (King of Prussia), new concrete patios require a building permit. In Lower Merion, a Minor Grading Permit is required if the patio adds 1,000 sq ft or more of new hard surface. Bridgeport Borough, Norristown, and Conshohocken Borough also require permits for patios that involve digging. NextGen Masonry handles permit research and filing for every project — we confirm requirements with the local building department before the estimate is finalized.

  3. Q.03

    What is the difference between stamped concrete and pavers?

    Stamped concrete is poured-in-place concrete with a texture and color pattern pressed into the surface before it fully cures. It creates a single seamless slab that mimics the look of pavers or stone. Actual pavers are individual stones set in sand or mortar over a compacted stone base. Pavers let you swap a single unit if a section heaves or cracks; stamped concrete gives you a seamless look and usually a lower installed cost per square foot. Both are durable when properly installed — the difference in how long they last comes from the base prep underneath, not the surface material.

  4. Q.04

    Can a concrete patio be poured against an existing house foundation?

    Yes, but an isolation joint — a compressible foam backer rod and sealant, not a plain cold joint — must be placed between the slab and the foundation wall. This allows the patio slab to move independently from the foundation as soils shift seasonally. If a patio is poured tight against a foundation without an isolation joint, the slab will eventually crack or push against the foundation wall as it moves. NextGen Masonry includes isolation joints at all structure interfaces on every patio project.

  5. Q.05

    How soon can I use the patio after it is poured?

    Foot traffic is safe 24–48 hours after the pour under normal temperatures. Furniture can go on at 7 days. Full strength (4,000 psi) is reached at 28 days. Don't drive or park on a patio slab — it's built for foot traffic, not the weight of a parked car. Cure time can be longer in cold weather: below 50°F, concrete gains strength more slowly, and the crew may use insulating blankets and heated enclosures to keep the slab warm enough to cure.
